General overview
The Weighted Bid Prices module of the Construction Project Estimator is intended
to provide access to timely average mean and median bid price data. Project bid
data will be updated weekly to reflect the most recent bids received by MassDOT-
Highway Division.
The database uses all bid data received in responsive bids, not just the low bid.
The bid prices are displayed in groups of increasing quantities. The limits of these
groups will be revised as additional bid data is obtained, and is intended to provide
an indication of bid price variations as quantities increase. The bid data is analyzed
to remove very high and very low bids.
The website is designed to provide a range of information about historical bid values
for any particular item. It is not intended to provide absolute values for each
item.
FAQ
Here are some frequently asked questions about this application.
Q: What does the 'Weighted Bid Prices' module of this
application do?
A:The 'Weighted Bid Prices' module is intended to provide access to timely
average mean and median bid price data. Project bid data will be updated weekly
to reflect the most recent bids received by MassDOT-Highway Division.
Q: What bids are used to calculate the weighted bid
prices?
A: The database uses all bid data received in responsive bids,
not just the low bid. The bid prices are displayed in groups of increasing quantities.
The limits of these groups will be revised as additional bid data is obtained, and
is intended to provide an indication of bid price variations as quantities increase.
The bid data is analyzed to remove very high and very low bids. The application
is designed to provide a range of information about historical bid values for any
particular item. It is not intended to provide absolute values for each item.
Q: How is bid data processed by the "Weighted Bid
Prices" module?
A: Once the system has identified all bids meeting the selected criteria,
the following analytical processes will occur:
- Project bids are ordered by project quantity
- The lowest quantity is subtracted from the highest quantity
- The result is divided by the items’ quantity group factor creating the appropriate
number of equalized quantity groups.
- All bids are distributed to their appropriate quantity group
- The median price is determined for each quantity group
- The items’ variance percent is applied to the median price for each quantity group
in order to create a high median and a low median for each group
- All bids falling outside the high median and low median ranges for each quantity
group are discarded
- A new median price is determined for each quantity group.
- The mean price for each quantity group is calculated.
Q: What are very high and very low bids?
A: These are bid prices determined to be excessively high or low when
compared to the median bid price of all bids for a given item. This determination
is based on calculating the items’ high/low median price as follows:
- high = median price + (median price * variance percentage)
- low = median price – (median price * variance percentage)
Since individual bids falling outside this high/low range, may skew the averages,
they are ignored.
Have a question not answered here or on the Help
page? More help is only an
email away.
Glossary
Here are some terms you may find throughout this application.
- Project Number: This is a field in which the user will specify
the Project Number for which this preliminary estimate is being created. The project
number is the unique identifier of the project in ProjectInfo (MassDOT-Highway
Division’s project tracking system).
- Project Description: Text description of the
construction work. Field is limited to 60 characters.
- MassDOT-Highway Division District: Identifies the MassDOT-Highway District responsible

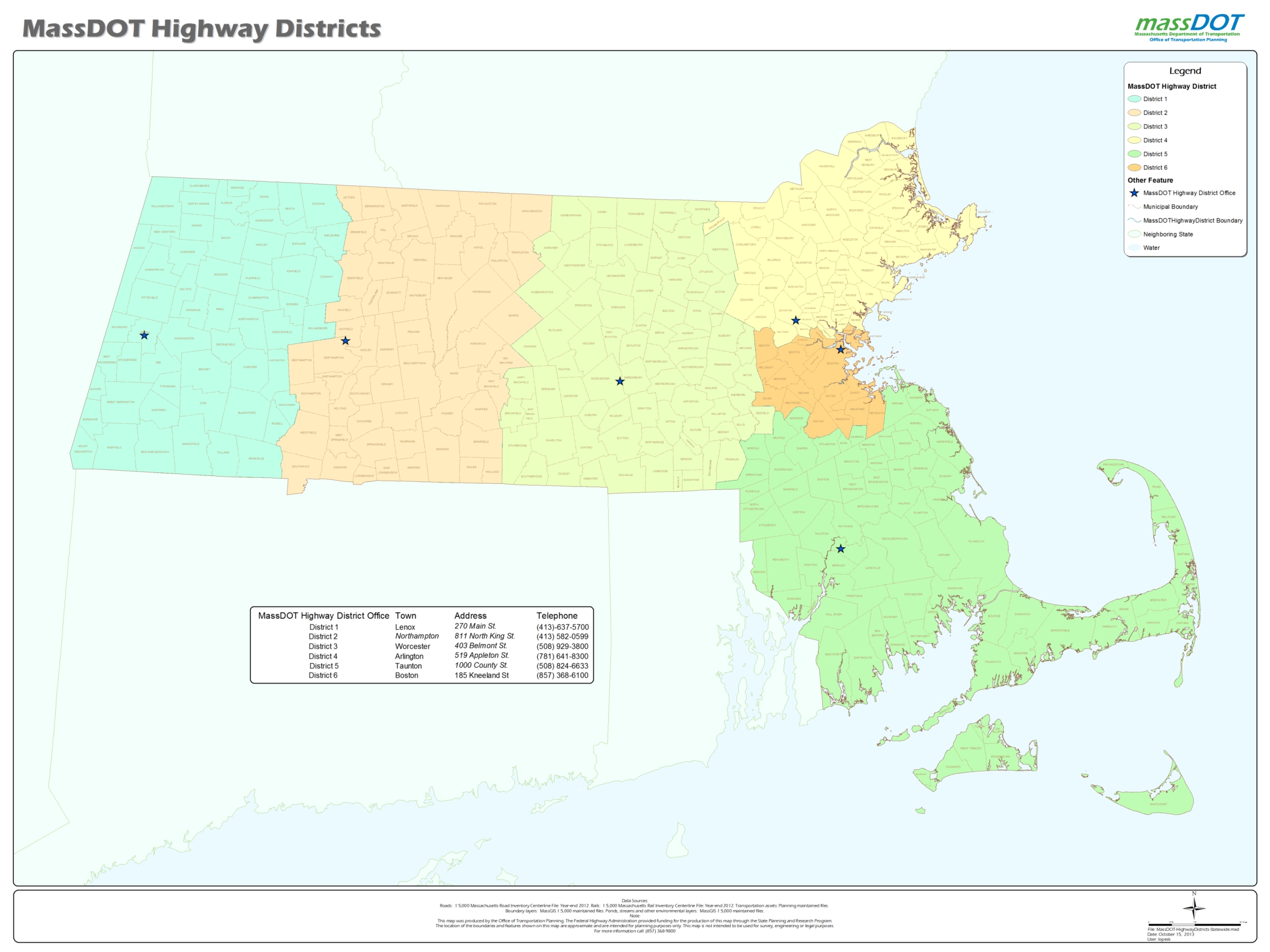

for the construction. The following are the valid values for a District:
1-6: Current Highway Districts
- Measurement System: E: English measurement system;
M: Metric measurement system
- Vendor Bids: Only responsive bids are considered.
A bid may be declared non-responsive by MassDOT-Highway for many reasons such as
clerical or mathematical error, or in response to the vendor's request to withdraw
there bid. Also certain unit prices may be considered too high or too low to participate
in the computing of the statistics. A variance level is defined for each line item
where prices are considered appropriate to participate in the statistics.
- Item No: Item number, an identifier of an activity
to be performed. If you enter an item number that corresponds to a MassDOT-Highway
standard line number, the description, units and type fields will be overridden
automatically by the MassDOT-Highway standard values. You are also allowed to enter
a non-standard item number.
- Units: How the item is measured. The unit must
agree with the measurement system chosen in the header. A list of valid units of
measure is available at the end of this page.
- Type: This is a field which is automatically populated based on
the item number selected.
Blank: Standard item
Noted with *: Standard item requiring
a special provision
- Unit Price: How the item is measured. The unit
must agree with the measurement system chosen in the header. A list of valid units
of measure is available at the end of this page.
- Minimum: The minimum unit price from the vendor
bids.
- Maximum: The maximum unit price from the vendor
bids.
- Quantity: Represents the quantity in the specified
units for the item.
- Min Quantity: The lower end of quantity interval.
- Max Quantity: The upper end of quantity interval.
- Mean: The average unit price.
- Median: The middle unit price, above and below
which lay an equal number of unit prices. This number is computed from the line
item statistics and is used as the default unit price for the line item.
- Responsive Bids: Bids determined to be "acceptable"
by MassDOT-Highway.
Bids determined to be "unacceptable" may be:
- Bids declared "rejected" or "non-responsive" due to clerical and/or mathematical
error.
- Bids with the approval of MassDOT-Highway Division, withdrawn at the bidders
requested.
Standard Units of Measure
Unit
|
Description
|
Measurement System
|
$
|
US DOLLARS
|
English and Metric
|
ALS
|
ANNUAL LUMP SUM
|
English and Metric
|
BAG
|
PER BAG
|
English and Metric
|
CAR
|
PER CAR
|
English and Metric
|
CNG
|
PER CLEANING
|
English and Metric
|
CUT
|
PER CUT
|
English and Metric
|
DAY
|
PER DAY
|
English and Metric
|
DD
|
PER DRUM DAY
|
English and Metric
|
DRM
|
PER DRUM
|
English and Metric
|
EA
|
EACH
|
English and Metric
|
FLR
|
PER FLOOR
|
English and Metric
|
HR
|
PER HOUR
|
English and Metric
|
HRS
|
PER HOUR
|
English and Metric
|
LS
|
LUMP SUM
|
English and Metric
|
MD
|
PER MAN DAY
|
English and Metric
|
MH
|
PER MAN HOUR
|
English and Metric
|
MO
|
PER MONTH
|
English and Metric
|
SD
|
PER SPACE DAY
|
English and Metric
|
SPT
|
PER SPOT
|
English and Metric
|
U
|
PER UNIT
|
English and Metric
|
UD
|
PER UNIT DAY
|
English and Metric
|
WK
|
PER WEEK
|
English and Metric
|
MMG
|
PER MILLION GAL
|
English
|
VF
|
PER VERT. FT.
|
English
|
UC
|
**CA/T USE ONLY
|
English
|
SY
|
PER SQUARE YARD
|
English
|
TON
|
PER TON
|
English
|
TPM
|
**CA/T USE ONLY
|
English
|
SF
|
PER SQUARE FOOT
|
English
|
SFD
|
**CA/T USE ONLY
|
English
|
SH
|
**CA/T USE ONLY
|
English
|
SI
|
PER SQUARE IN
|
English
|
MSF
|
**CA/T USE ONLY
|
English
|
OZ
|
PER OUNCE
|
English
|
QT
|
PER QUART
|
English
|
RIS
|
**CA/T USE ONLY
|
English
|
MBM
|
PER MFBM
|
English
|
MGL
|
PER 1000 GALS
|
English
|
|
Unit
|
Description
|
Measurement System
|
KWH
|
PER KILOWATT HR
|
English
|
GAL
|
PER GALLON
|
English
|
CY
|
PER CUBIC YARD
|
English
|
CSF
|
PER 100 SQ. FT.
|
English
|
LB
|
PER POUND
|
English
|
LBS
|
PER POUND
|
English
|
LD
|
**CA/T USE ONLY
|
English
|
LF
|
PER LINEAR FOOT
|
English
|
LFD
|
**CA/T USE ONLY
|
English
|
LI
|
PER LINEAR INCH
|
English
|
LM
|
PER LINEAR MILE
|
English
|
LOD
|
**CA/T USE ONLY
|
English
|
CCF
|
PER 100 CU.FT.
|
English
|
CF
|
PER CUBIC FOOT
|
English
|
CGL
|
PER 100 GALS
|
English
|
CH
|
**CA/T USE ONLY
|
English
|
CLF
|
PER 100 LIN FT.
|
English
|
BBL
|
PER BARREL
|
English
|
BF
|
PER BOARD FOOT
|
English
|
A
|
PER ACRE
|
English
|
AAA
|
**CA/T USE ONLY
|
English
|
AL
|
**CA/T USE ONLY
|
English
|
CM
|
PER CUBIC METER
|
Metric
|
CMM
|
PER CUBIC ARE
|
Metric
|
HA
|
PER HECTARE
|
Metric
|
L
|
PER LITER
|
Metric
|
Metric
|
PER METER
|
Metric
|
KG
|
PER KILOGRAM
|
Metric
|
KL
|
PER KILOLITER
|
Metric
|
KM
|
PER KILOMETER
|
Metric
|
MG
|
PER MEGAGRAM
|
Metric
|
MRD
|
PER METER DAY
|
Metric
|
MM
|
PER MILLIMETER
|
Metric
|
MT
|
PER METRIC TON
|
Metric
|
SM
|
PER SQ. METER
|
Metric
|
SMM
|
PER SQ. MM
|
Metric
|
VM
|
PER VERT. METER
|
Metric
|
|
|
|
|
Table 1: Table of standard MassDOT-Highway units of measure.
